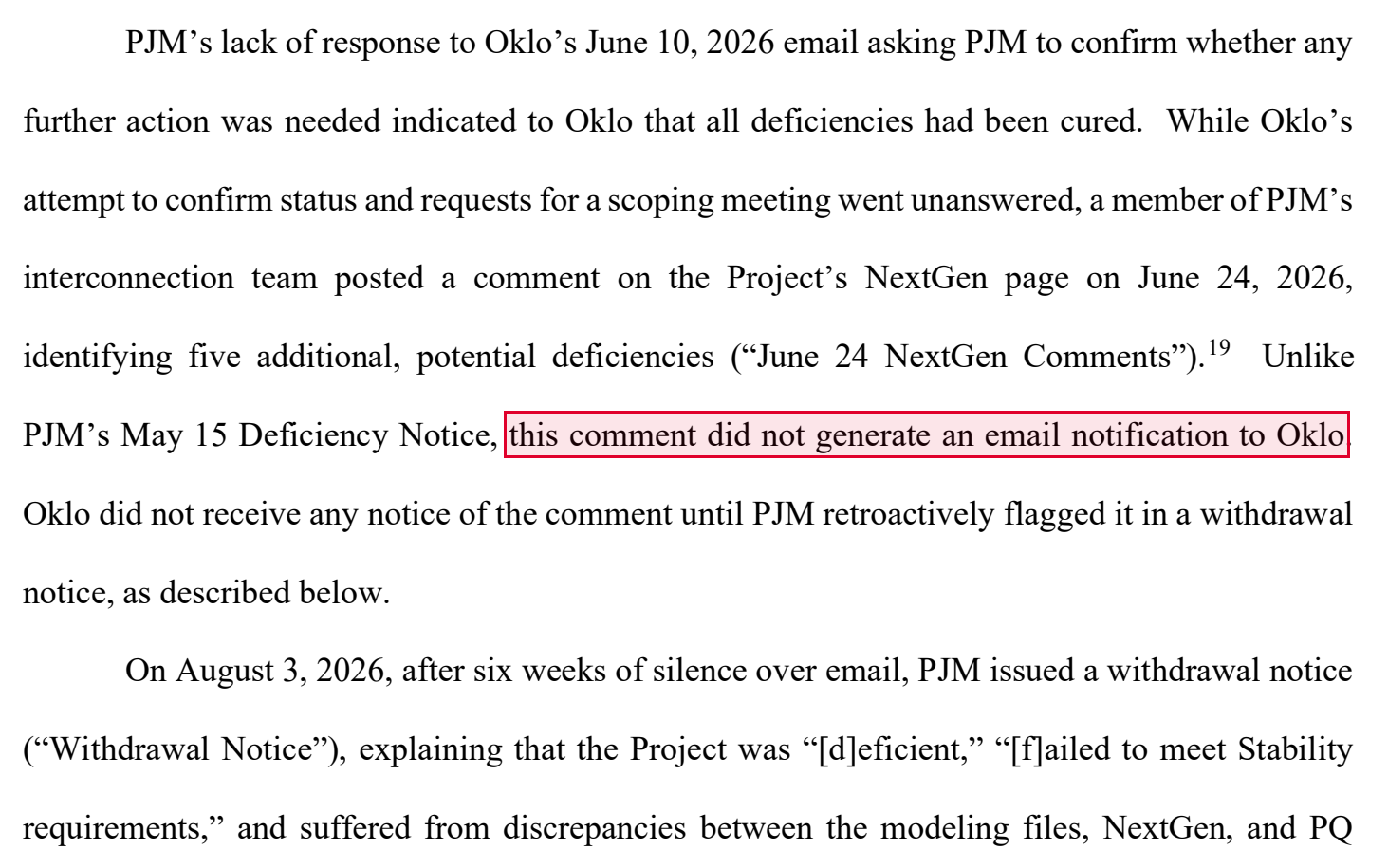

PJM withdrew Oklo's 750 MW interconnection request from its Cycle 01 study on August 3, the same day it announced 715 new generation projects had qualified into that cycle; the deficiency PJM relied on was a NextGen portal comment that sent no email notification and, per the complaint, went up on business day 41 against a 15-business-day tariff deadline
PJM pulled the $OKLO project out of the queue to connect to the grid the same day it put out a press release saying 715 new power projects had qualified to get into that same queue.
